San Antonio TX Tile Roof Replacement Case Study – Westlake Saxony Slate Concrete Tile | Greystone Country Estates

Presidio Roofing Company completed a full retail tile roof replacement at a two-story residential property in Greystone Country Estates, San Antonio, TX 78258, covering 8,300 sq ft (83 squares) at a predominantly 8-10/12 pitch. The scope involved tearing off the original concrete tile roof to the decking, installing a high-temperature self-adhering leak barrier underlayment across the full deck surface including all hips, ridges, and valleys, and laying Westlake Saxony Country Split Shake Tile (Cobblestone). The steep pitch and scale required forklifts and long-arm telehandlers for material handling. This was a retail replacement valued at $140,000-$170,000, backed by a Westlake Lifetime Warranty with a 10-year workmanship guarantee. The project was completed in October 2024.

In This Case Study:

Project Snapshot: Key Specifications & Costs

Metric Project Detail
Project Type

Full Roof Replacement (Retail)

Location

Greystone Country Estates, San Antonio, TX 78258

Roof Size

8,300 Sq Ft (83 Squares)

Material Used

Westlake – Saxony Country Split Shake Tile (Cobblestone)

Duration

4 Weeks

Budget Range

$140,000 – $170,000

Warranty

Westlake Lifetime Warranty With 10-Year Workmanship

Introduction

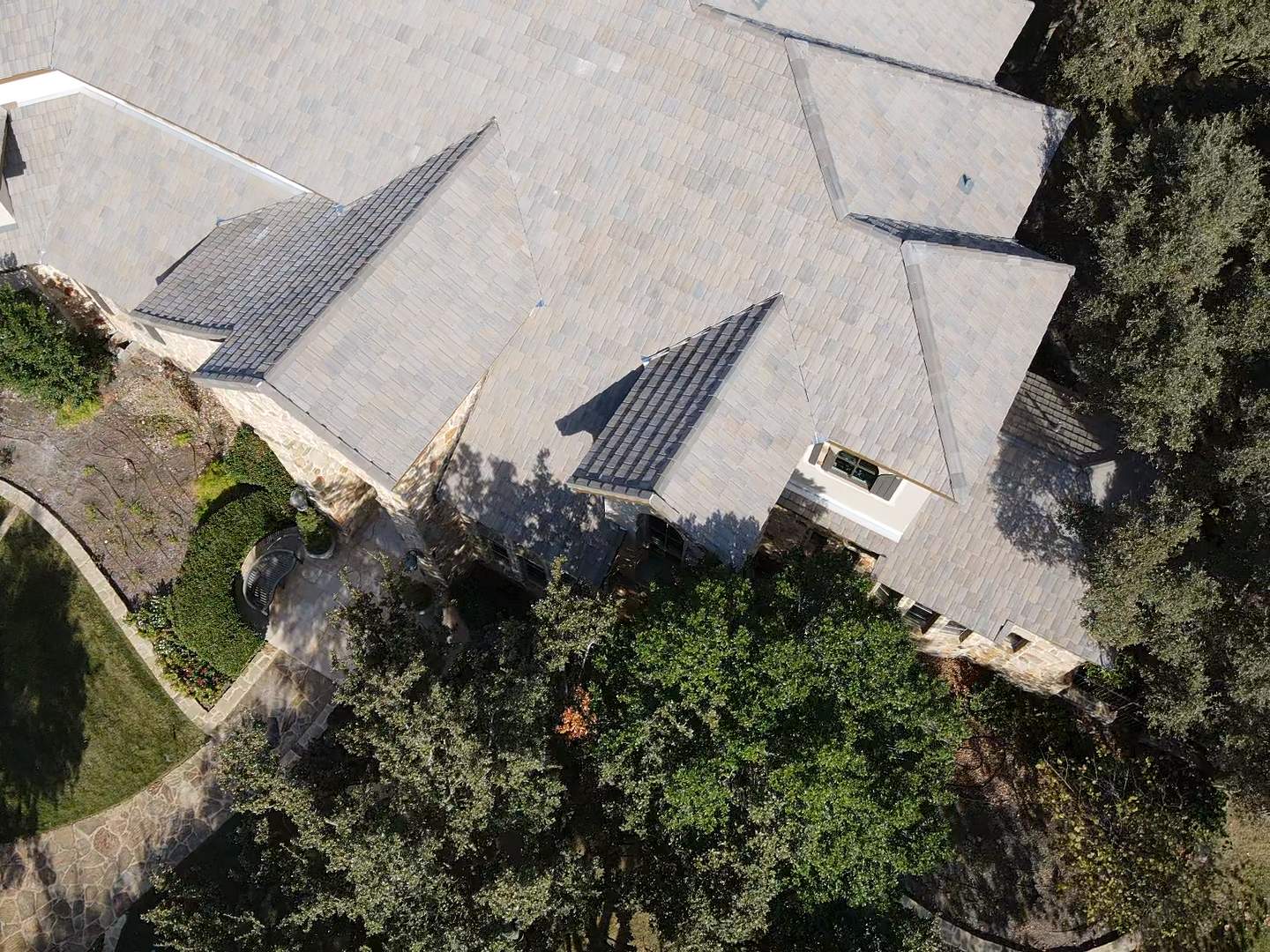

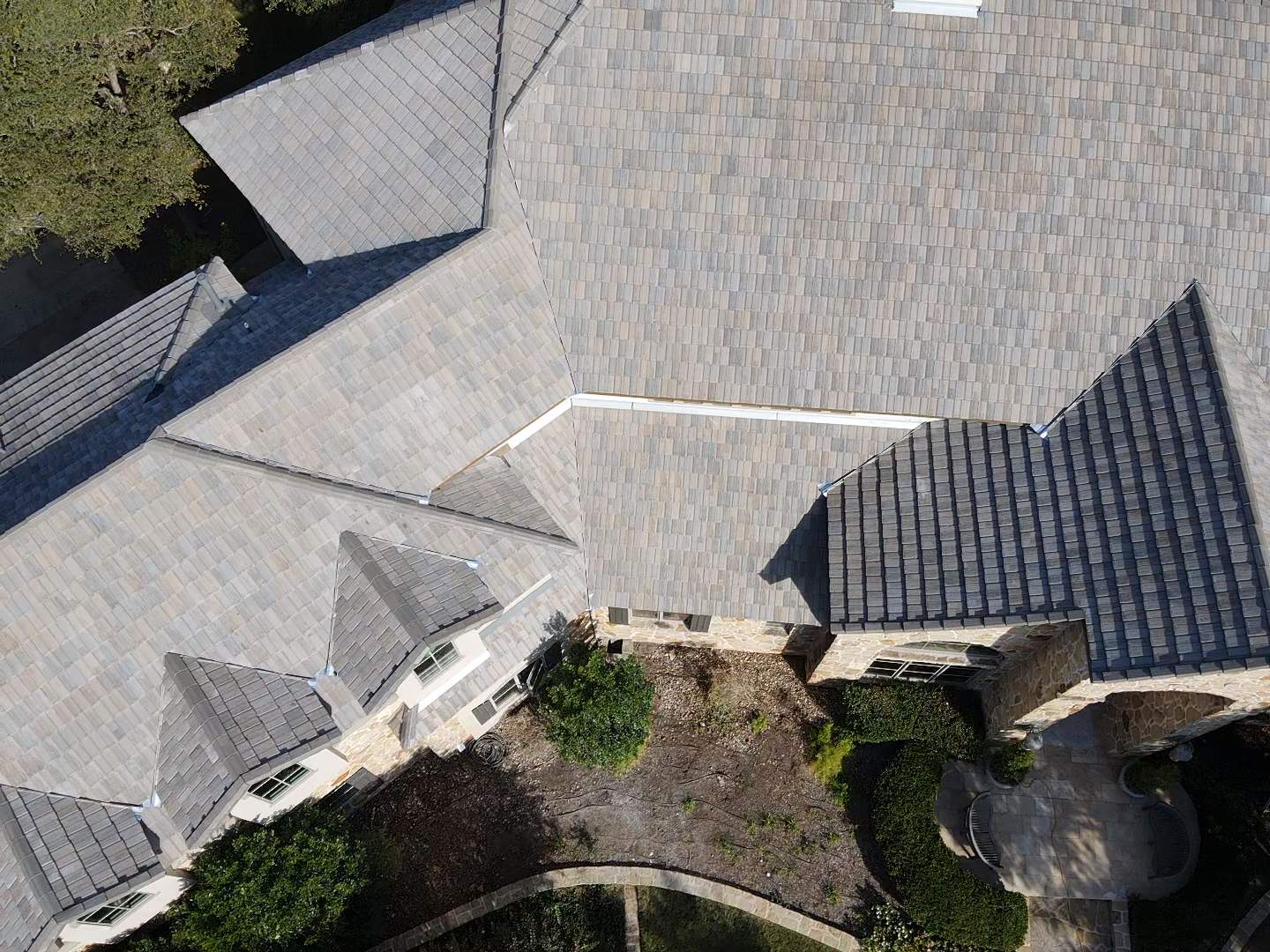

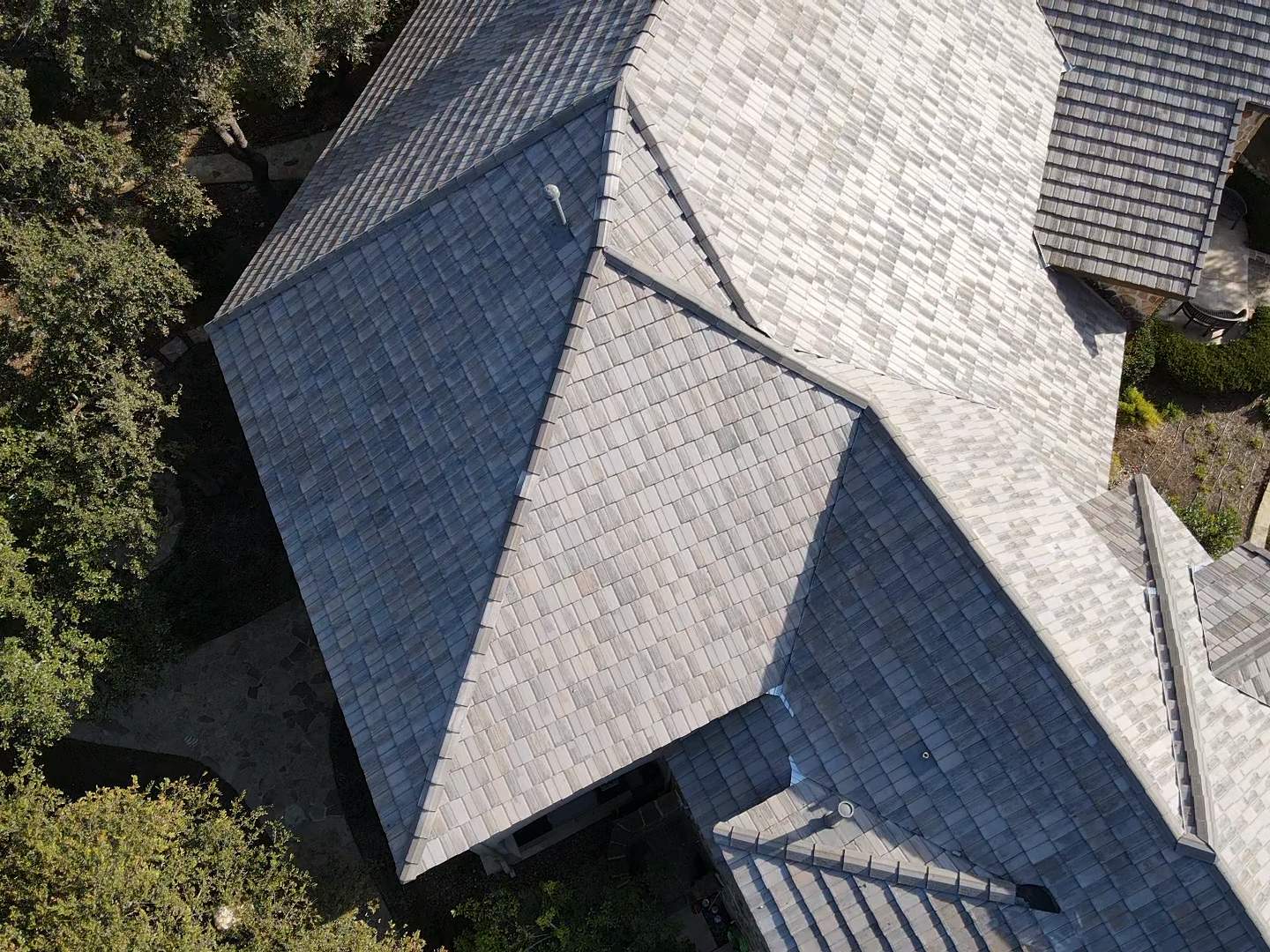

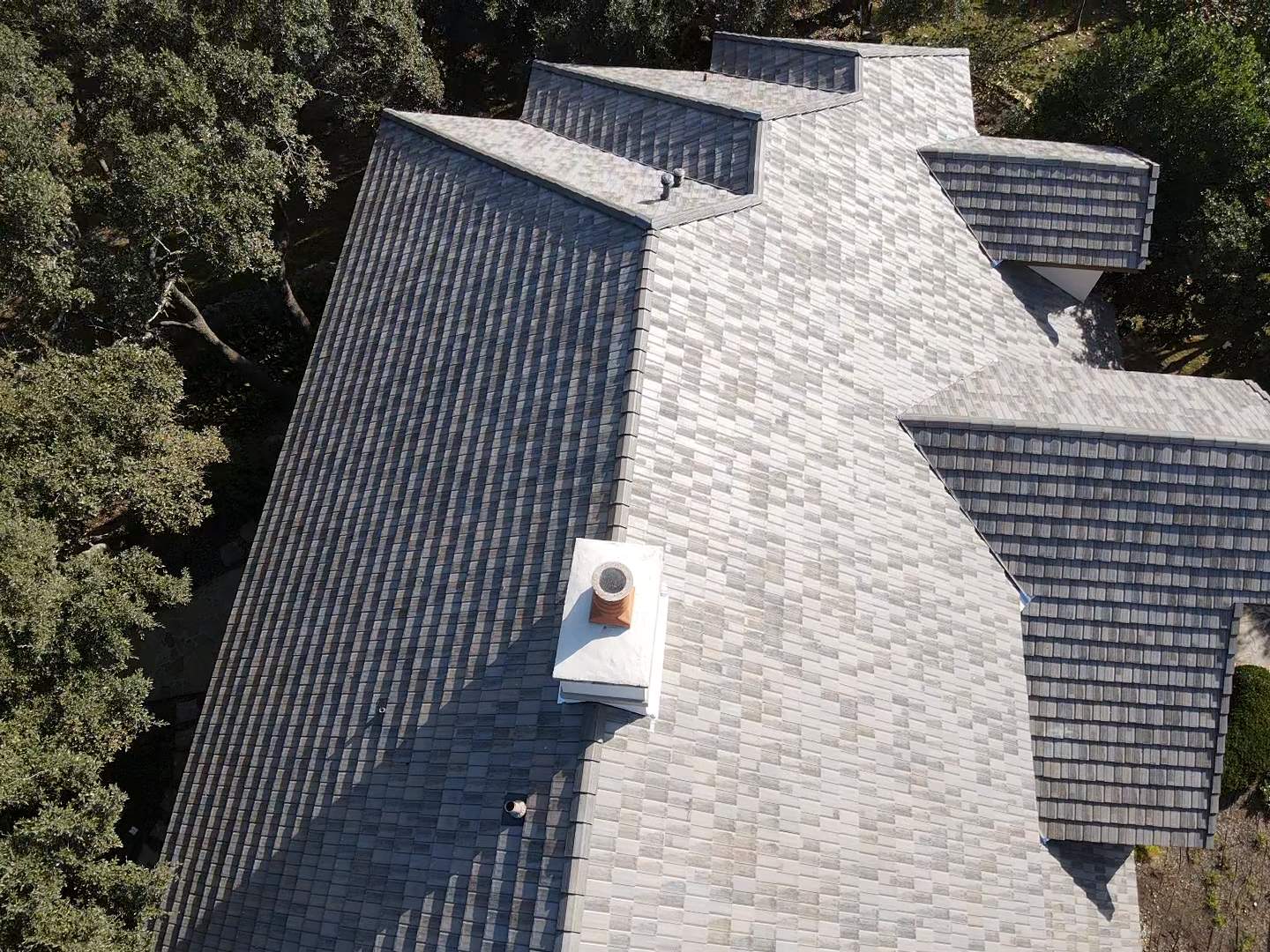

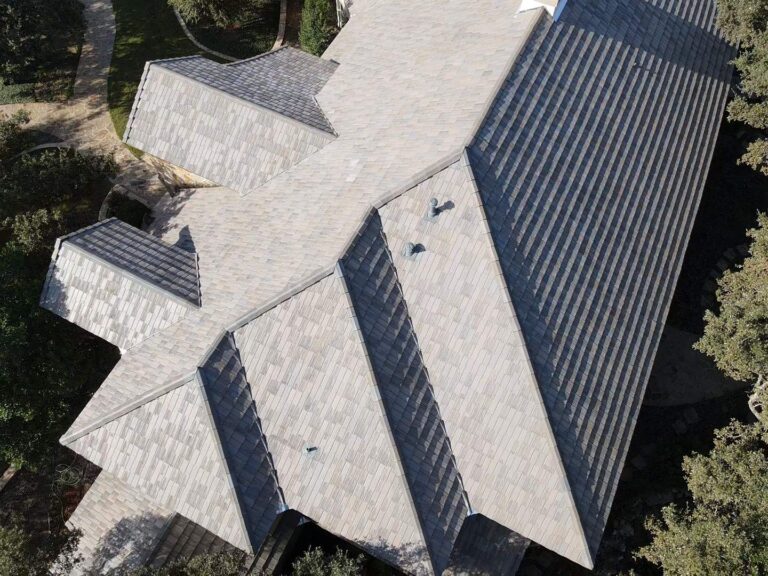

This case study covers the complete tile roof replacement Presidio Roofing performed for a residential property in Greystone Country Estates, San Antonio, TX. The project involved removing old concrete tiles and installing Westlake – Saxony Country Split Shake Tiles to stop water from getting into the home. It was completed in October 2024 and covered 8,300 sq ft.

We tore off the original tile roof to the decking. The decking didn’t need replacement. We installed a high-temp self-adhering leak barrier underlayment across the entire deck, over all hips, ridges, and valleys. That creates a sealed, watertight surface for the tile to go onto. The difference compared to standard felt paper matters when things go wrong – if hail or wind damages the tile on this roof, the risk of an actual leak is very low. Your underlayment keeps water out. The tile protects that underlayment.

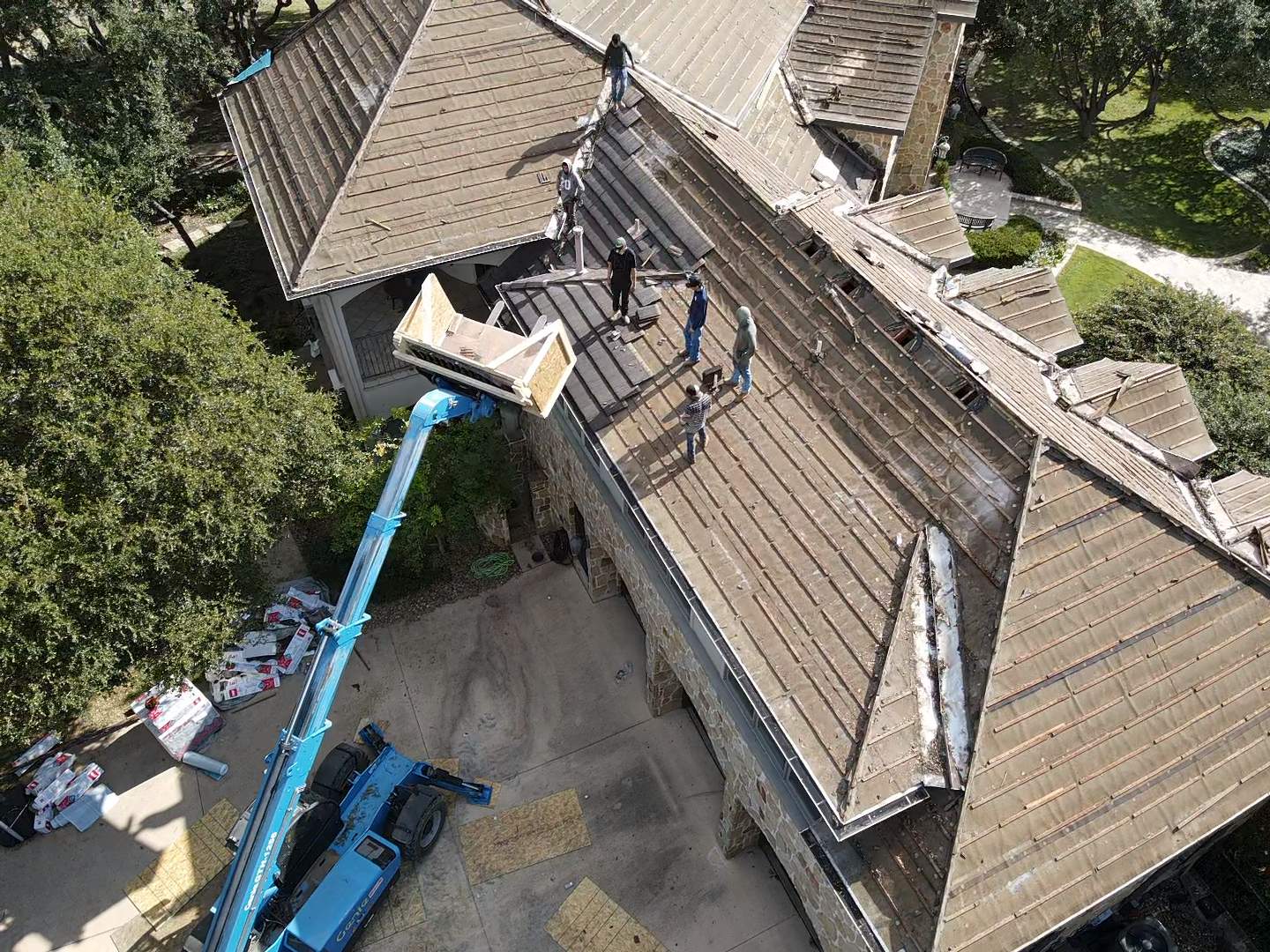

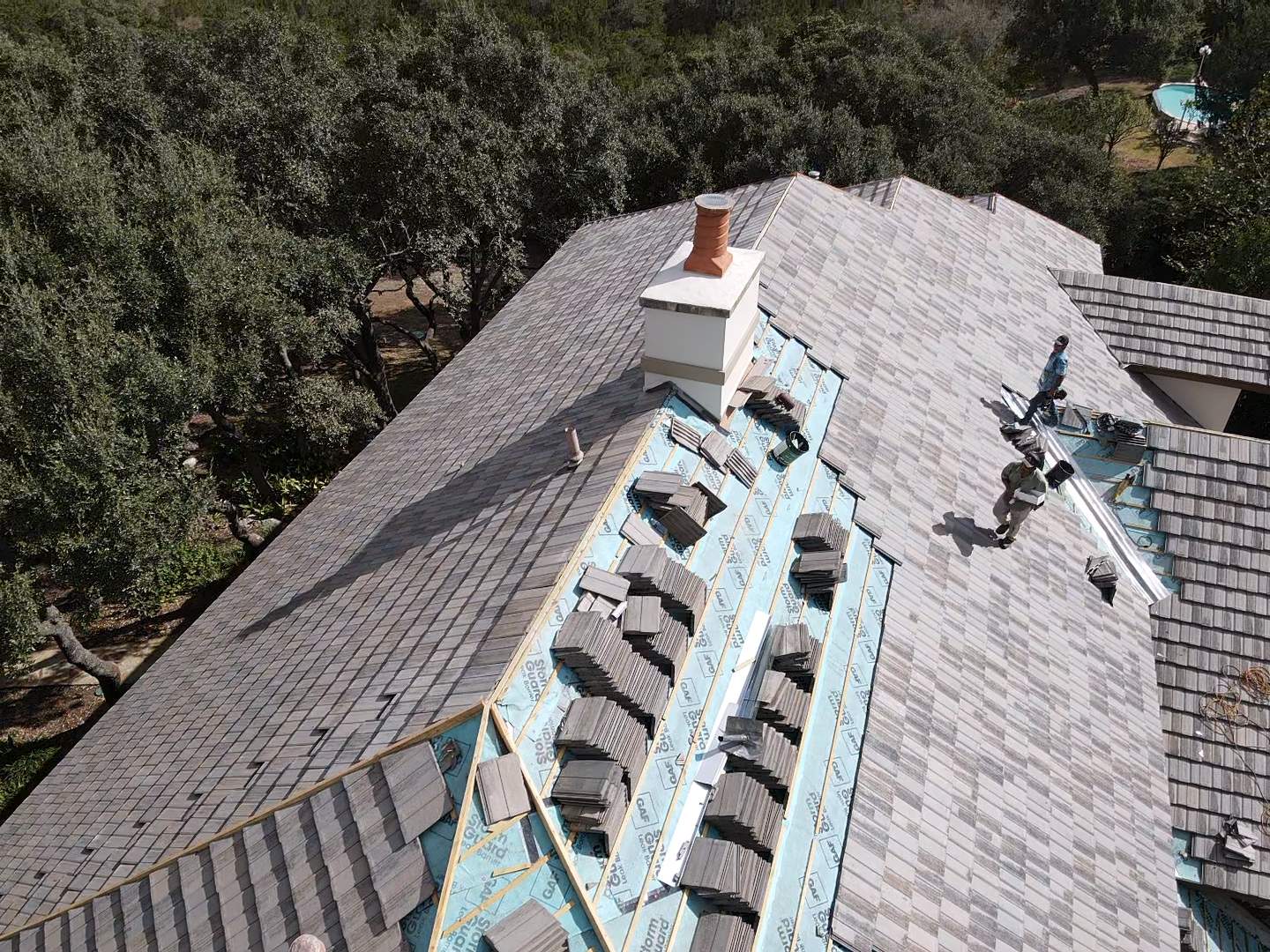

Large tile jobs like this need dumpsters, forklifts, and long-arm telehandlers for getting material onto the roof. This job took 4 weeks to complete. We installed a concrete split shake style tile by Newpoint, which was formerly Boral, under the Westlake company brand.

Challenge 1: Dangerous & Steep Work Conditions

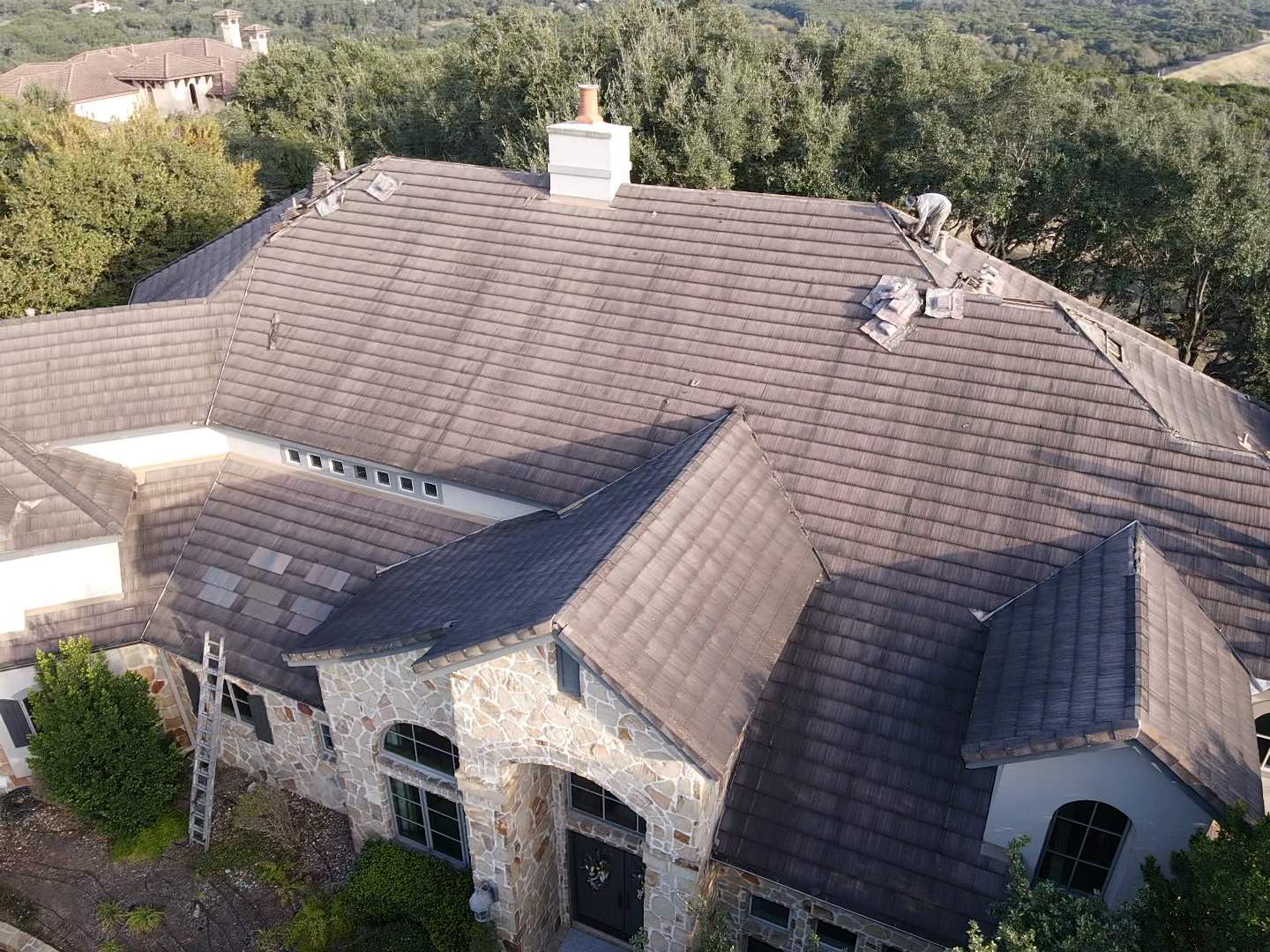

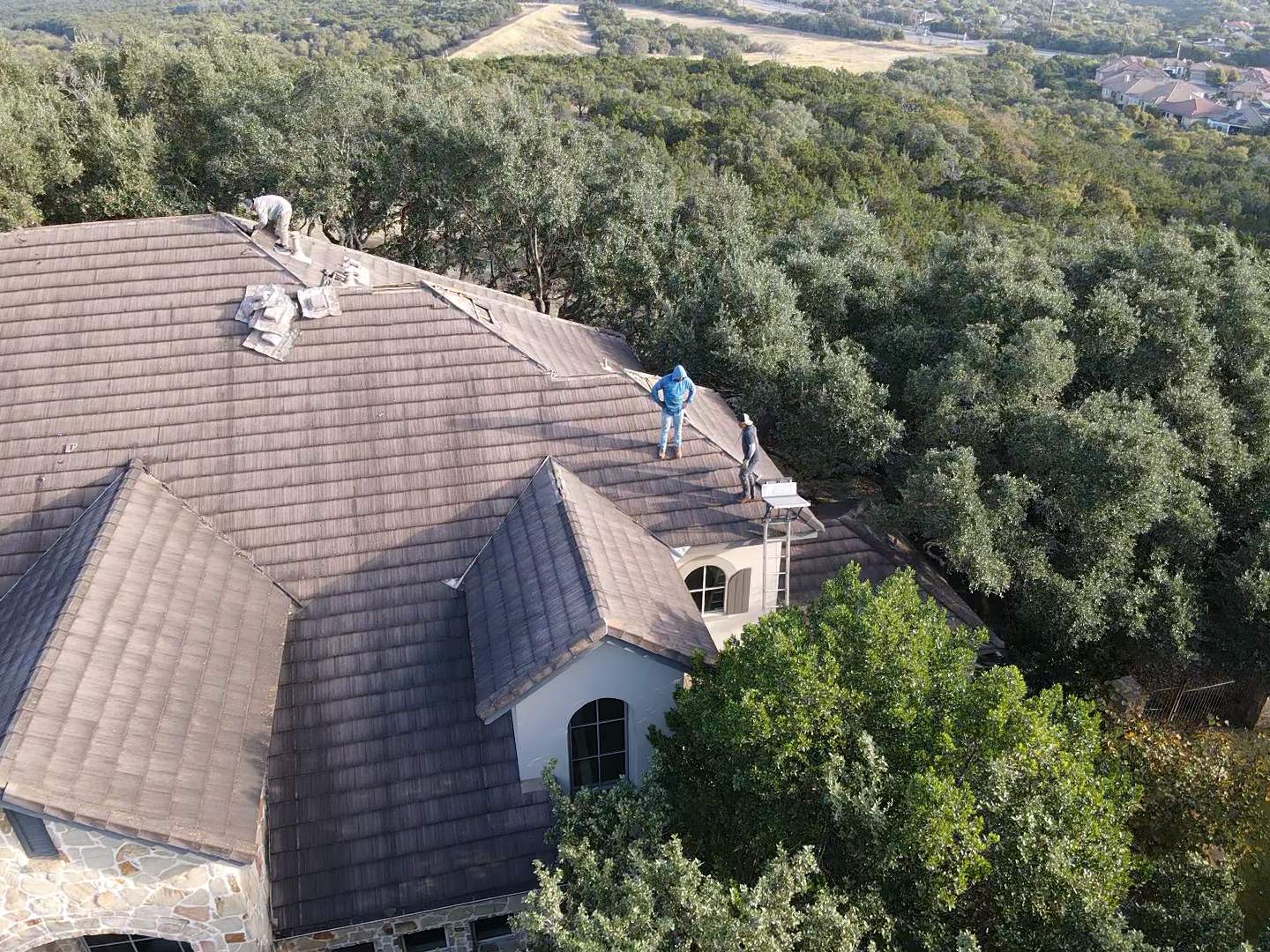

This is a 2-story roof with a steep pitch – predominantly 8-10/12, running from nearly 34 to nearly 40 degrees. Tile is heavy. That weight compounds every part of the job compared to shingles – tear-off, loading materials, moving them into position, cutting them. On a roof this difficult to walk, the steepness makes the work more dangerous, slows the pace, and demands closer attention to the small things.

The Solution: Experience, Safety Systems & the Right Equipment

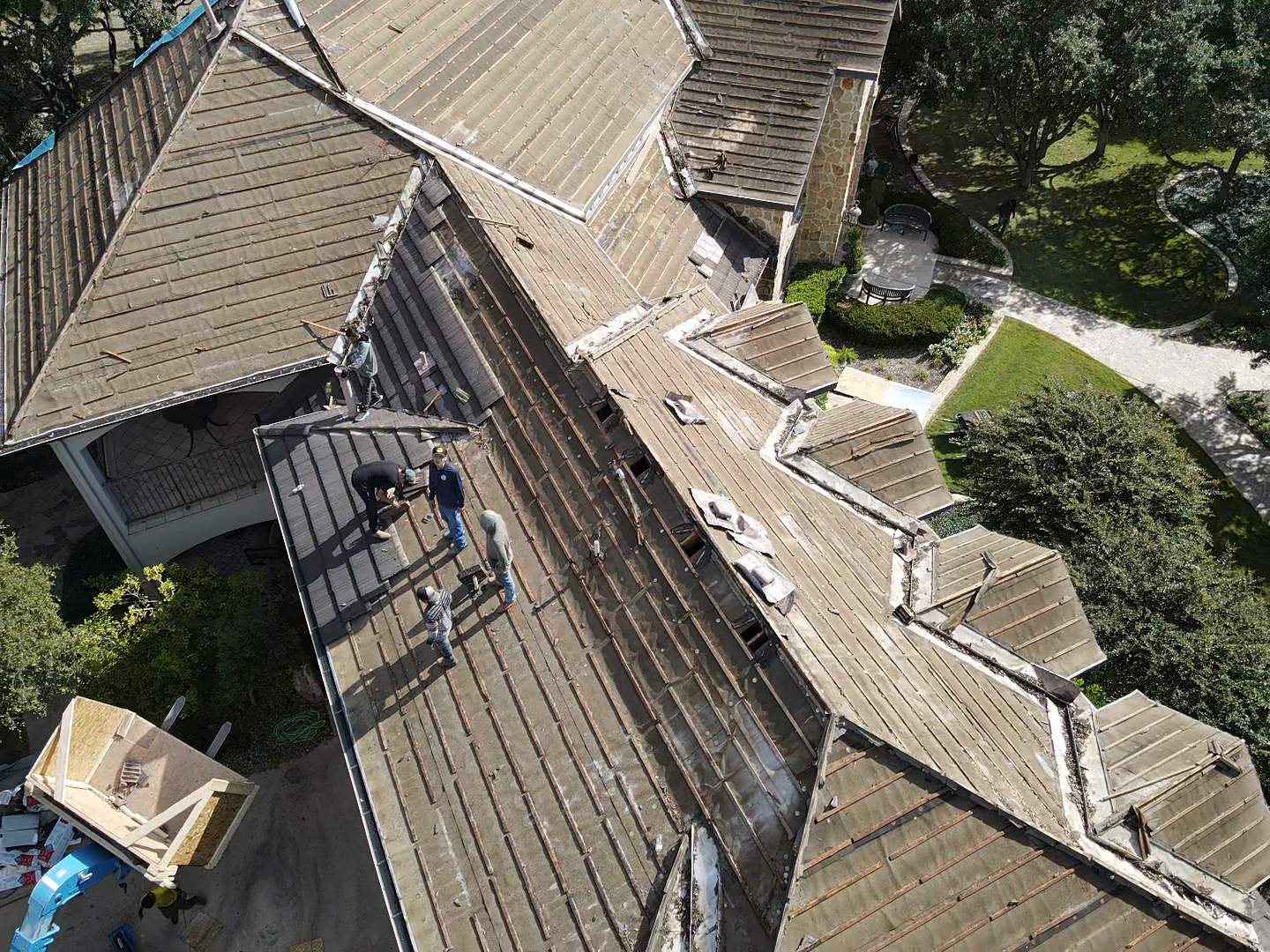

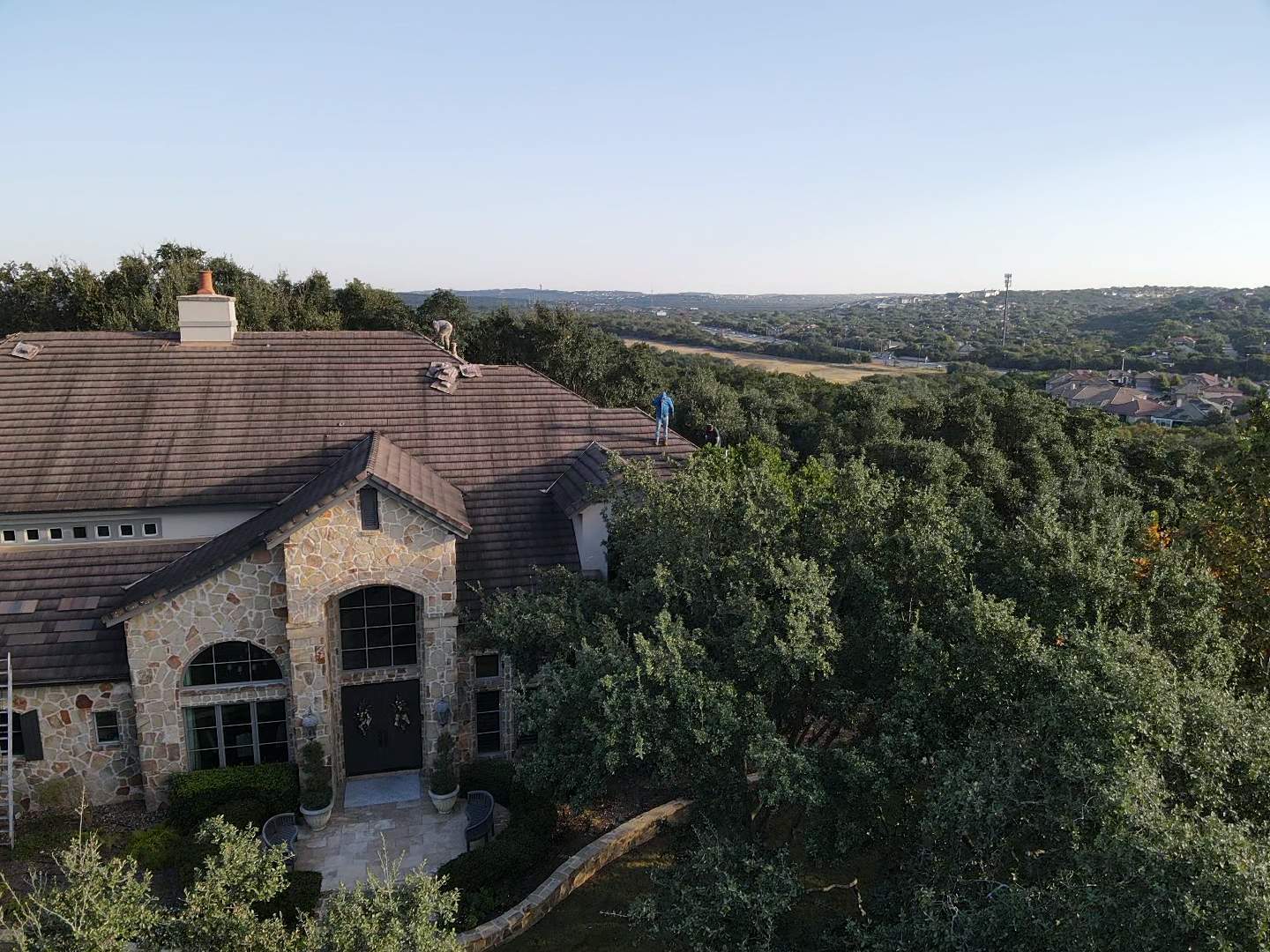

We’ve worked steep, 2-story tile roofs all over Texas – Port Aransas, DFW, and across San Antonio and the hill country. Some neighborhoods run even steeper than this, like the Dominion, and we’ve completed many replacements there. On these roofs our crew adds safety measures: more ground coverage to catch falling tiles, rope and harnesses, bigger lift equipment, and more.

Challenge 2: We Found a Cactus Growing on the Roof

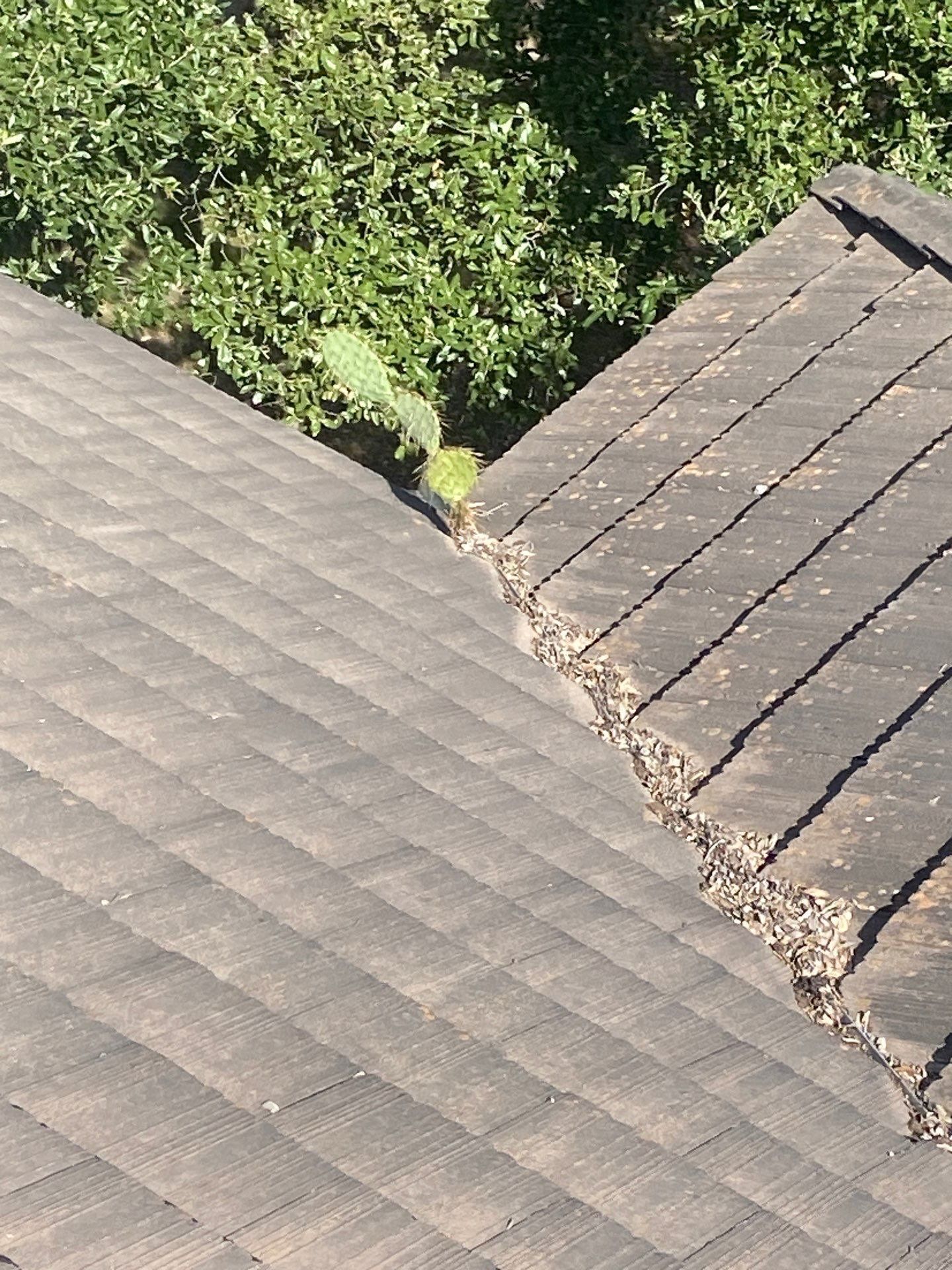

Yes, you read that right. A nearly 3-foot cactus was growing in the tile roof. We were concerned it might trigger a change order or uncover structural problems below.

The Solution: Proper Training, Experience & Our Skillset

Finding vegetation in tile roofs isn’t unusual in the Southern and Southwest U.S. Older tile roofs with organic underlayment can create good growing conditions for seed pods – given the right moisture and warmth, things sprout. High winds and animals like bats, which commonly burrow into older tile roofs, are the usual carriers.

Newer systems with better products and underlayment are far less prone to this. Still, it’s a solid reason to have a maintenance plan and stay ahead of vegetation or animal issues.

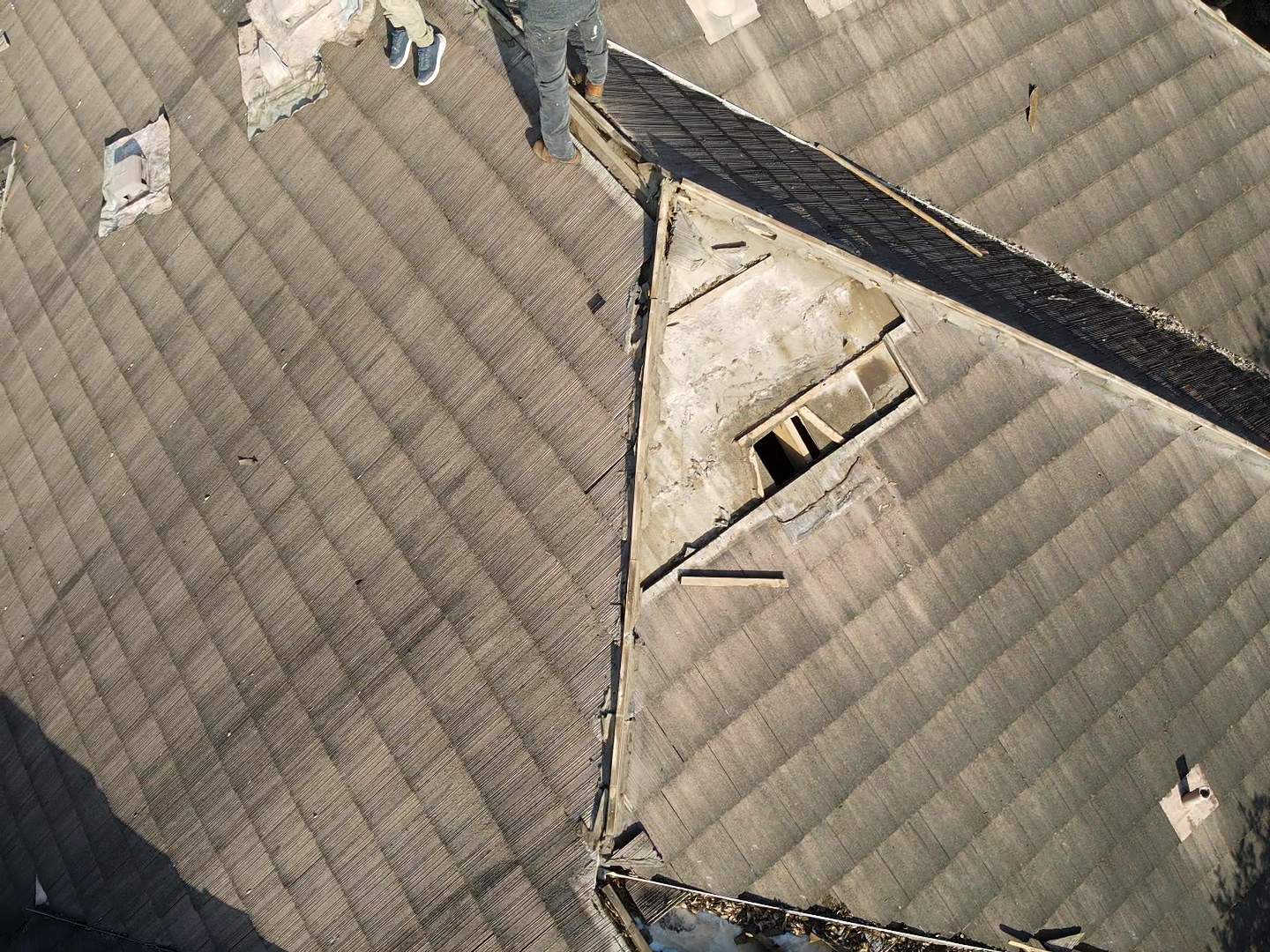

This growth was small enough that we removed it carefully. Had it been a different plant – one that had run roots under large sections of tile – we’d have been looking at structural issues and change orders. It’s something we can often catch before work even starts, and another reason to take the initial inspection seriously.

Challenge 3: Work Around Rain and Protect the Decking

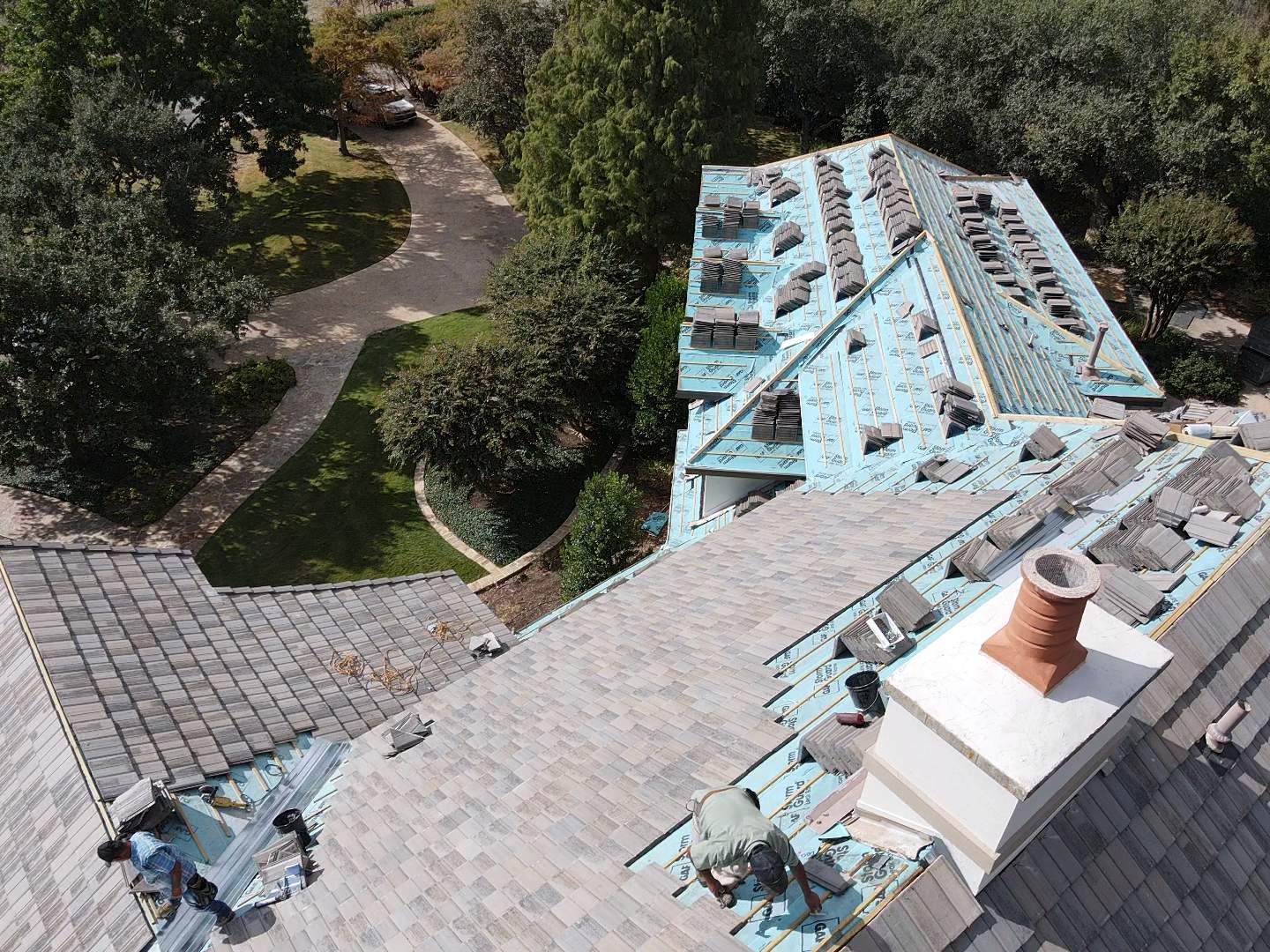

This was a large job, and we had to sequence the work carefully to keep the roof protected through any rain events during the build.

The Solution: Working With the Right People

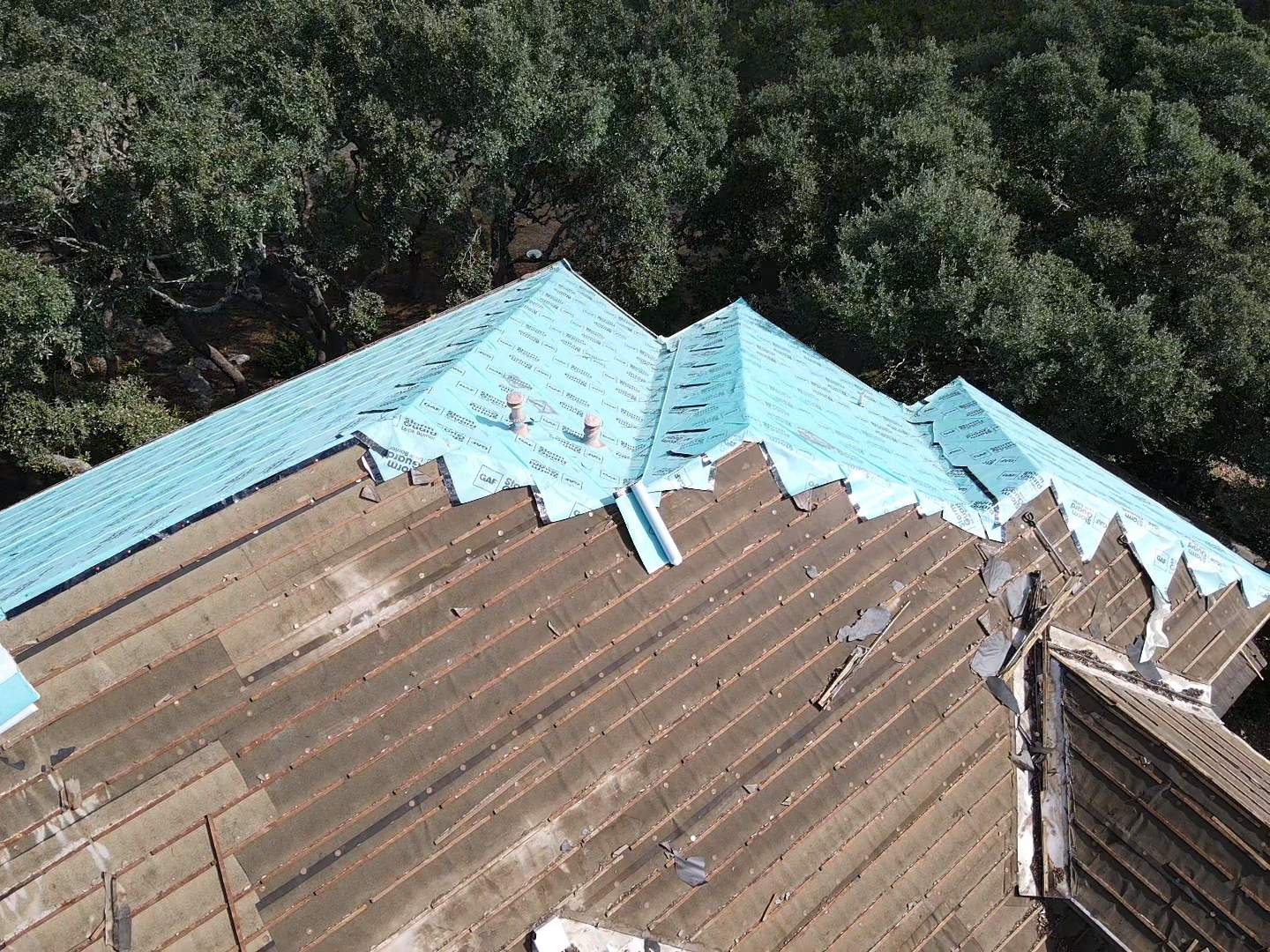

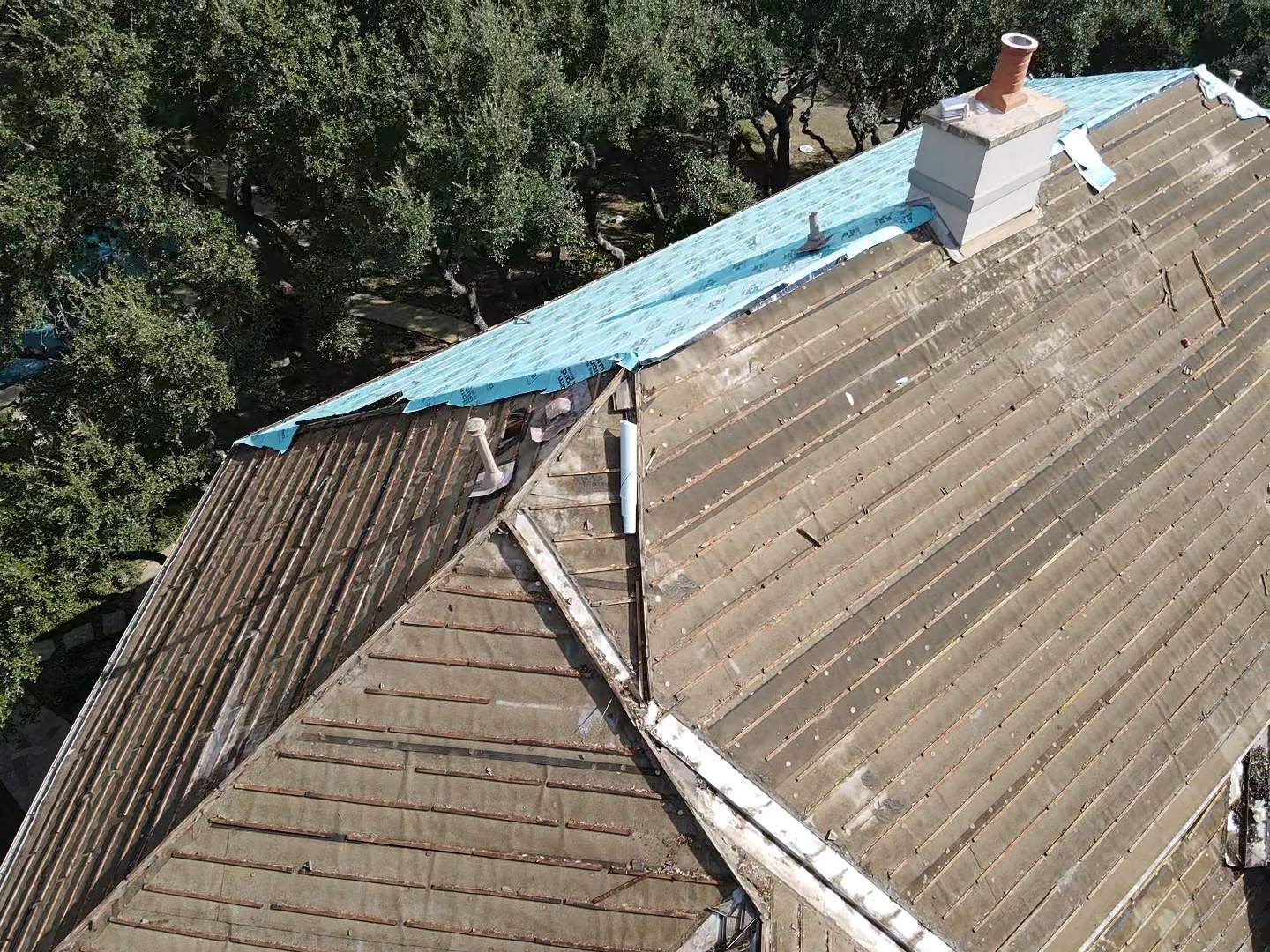

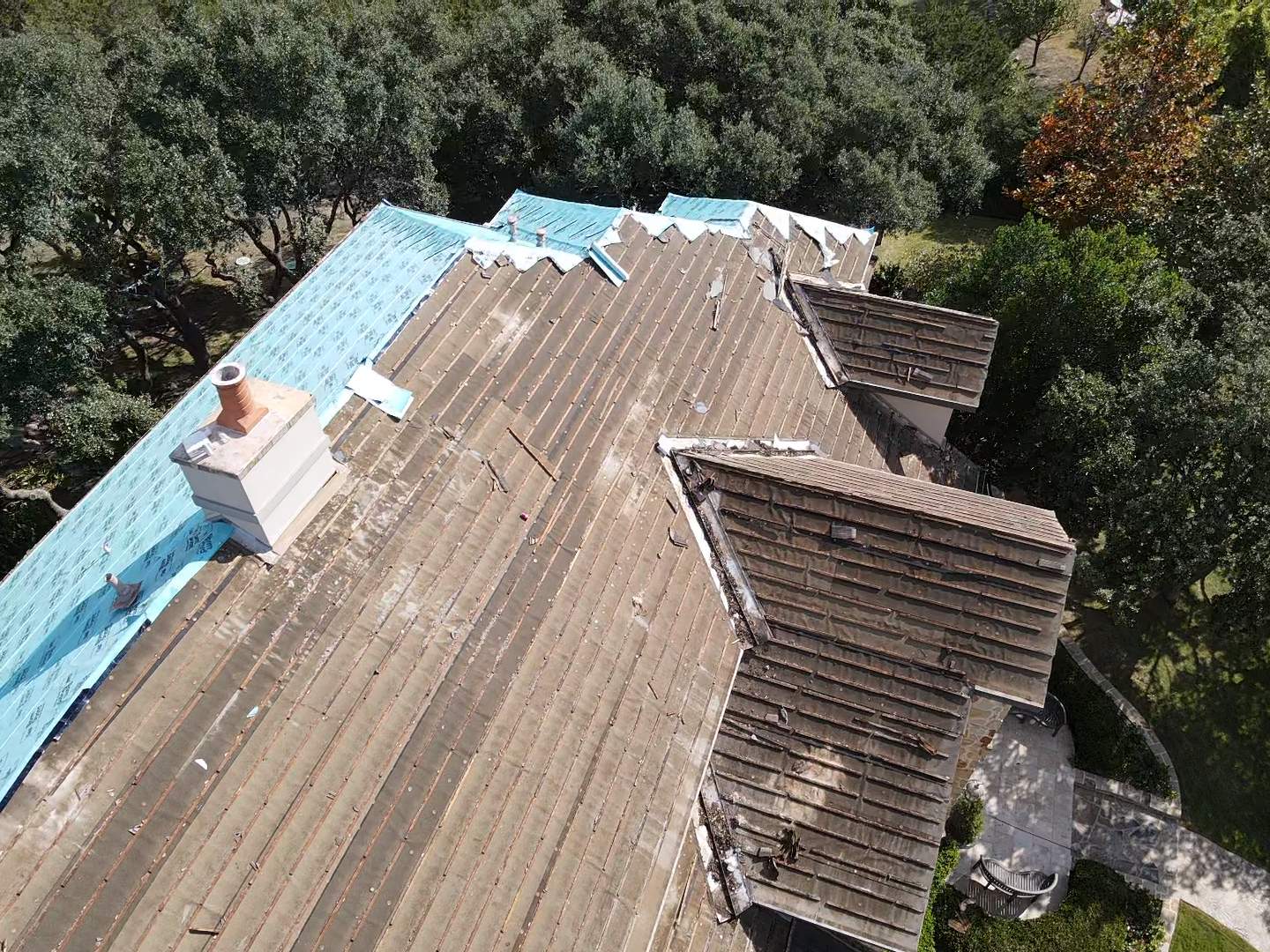

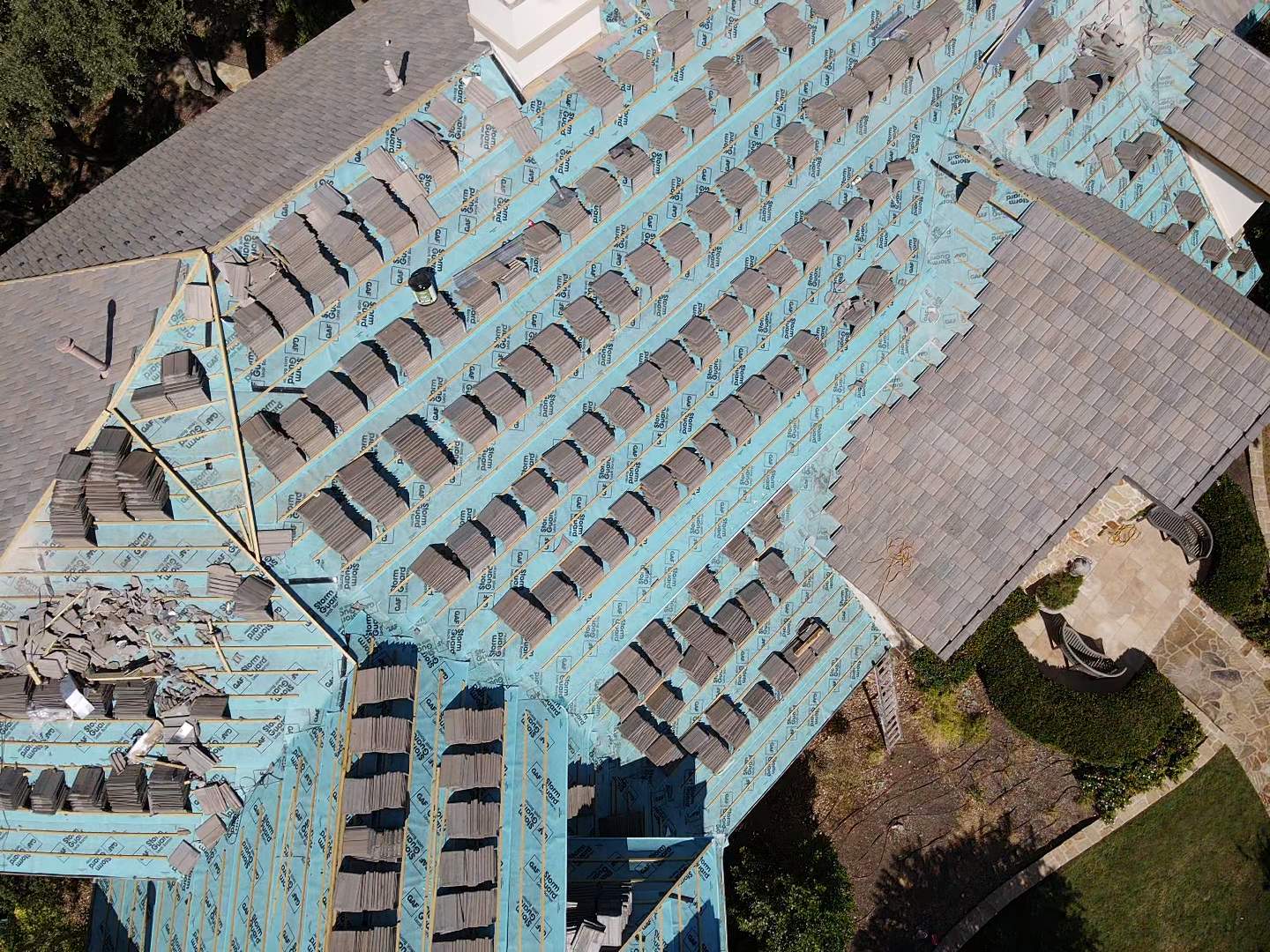

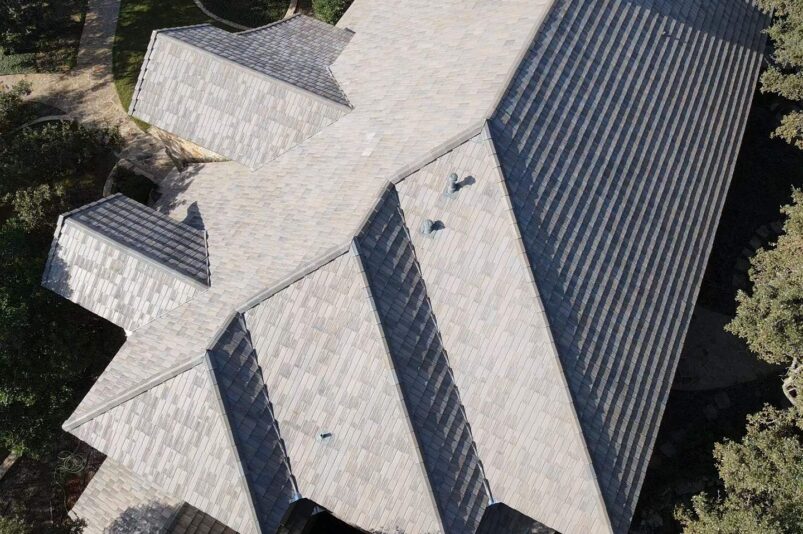

We tore off and dried in the roof in sections. That way the decking stays covered at all times, and a pop-up shower doesn’t turn into a bigger problem. In some of the photos you can see it clearly – parts of the roof showing the light blue of fresh underlayment while others still carry the worn look of the old tile and underlayment.

The Result

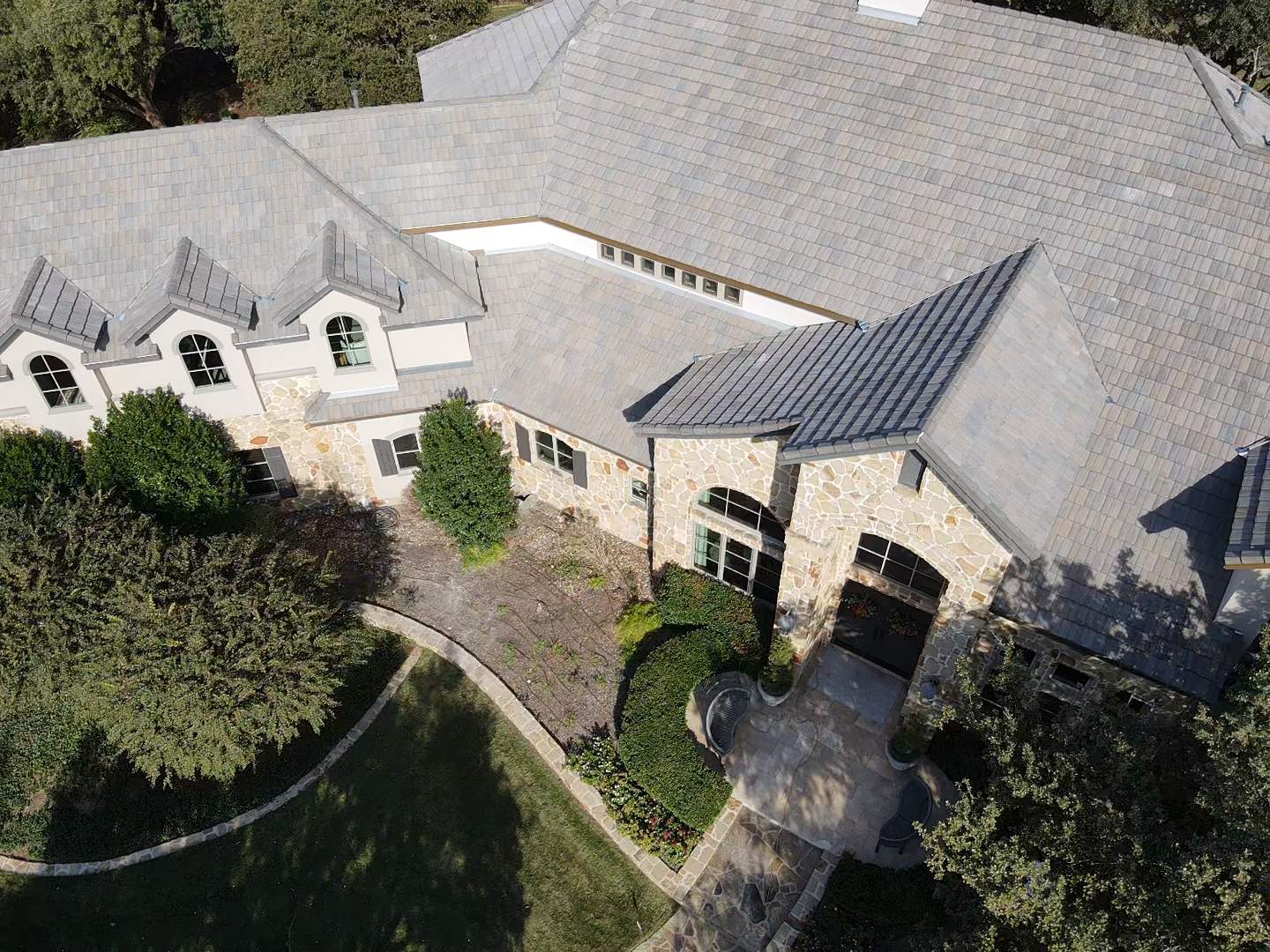

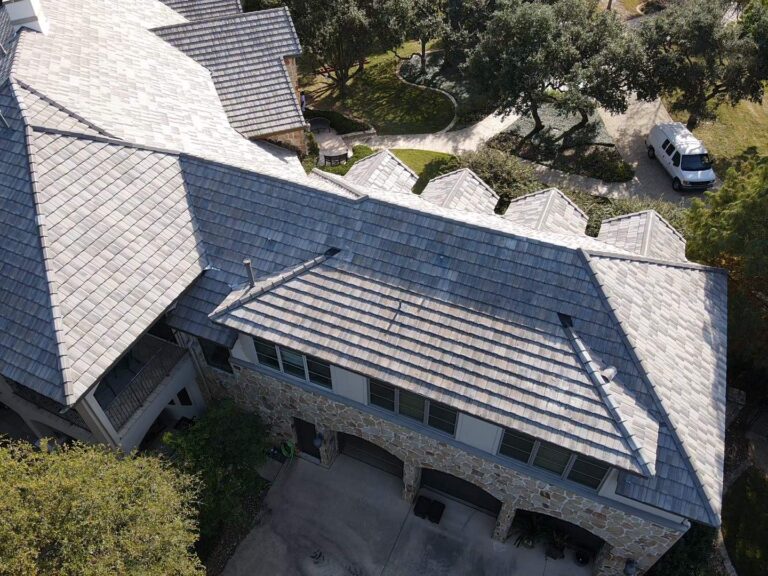

The project delivered a complete concrete tile roof replacement across 8,300 sq ft, wrapped up on schedule and completed in October 2024. The installed system carries a Westlake Lifetime Warranty backed by a 10-year workmanship guarantee.

The homeowner told us the finished roof was exactly what they had envisioned when they first contacted us – and that the phased approach kept the project moving without any weather-related setbacks. At $140,000-$170,000, this was a substantial project, and the roof it produced reflects that investment. Read more from clients who have been through the same process.

Jon Whitaker has exceptional experience and expertise. I am definitely contacting him if I have any roof issues in the future. You can count on Jon diagnosing your issues!
Lori
Lori
17:08 01 Jun 26
Went above and beyond to make sure our roof was patched up from a leak we had.
Kathryn Torres-Bloch
Kathryn Torres-Bloch
22:28 28 May 26
Presidio conducted a roof inspection, and from the first call I knew they would be honest and reliable. They gave me a call prior to the roof inspection and took the time to listen to our concerns leading to the inspection. The day of, their communication was great and follow up as well. I'd definitely recommend!
Vanessa Rabago
Vanessa Rabago
15:34 22 May 26
Great response and job done well
edward lee
edward lee
14:57 07 May 26
Presidio roofing did a great job with a full roof replacement in San Antonio. We live in Stone Oak and had a 25 year old roof that was past needing to be replaced that started leaking. Mike Tavenner came out and explained everything to us. Within a week they started work and finished the entire roof replacement in a day and a half. The crew did a nice job and they cleaned up all of the debris. We got multiple estimates but chose Presidio because we were confident with Mike. He was at the house a lot during the install making sure the project got completed the right way and on time. We appreciate everything.
Erik Cummings
Erik Cummings
15:20 06 May 26
Mike and Presidio Roofing did a great job replacing my 16-year-old roof! I lost a few shingles in a recent storm and knew my old roof was on borrowed time. I called Presidio Roofing based on a personal recommendation and seeing their advertising around. Mike came to my house and did a thorough evaluation including using a drone to get detailed photos of my roof and shared those with me to show me what was going on. The quote was reasonable considering their ratings and comparable quotes. They hooked me up with multiple quotes of different grades of roofing shingles and warranty information, even connected me with a solid company for financing the job. They hold a high tier rating with GAF, who is the largest retailer of roofing shingles in the nation to enable GAF’s warranties. From initial roof assessment to final roof replacement was a hair over a week which was outstanding! The crew was very experienced and on the day they came, they were done in half a day. I’d highly recommend their work and will call them again for any future roofing needs.
Eric Bailey
Eric Bailey
02:44 04 May 26
js_loader

How to Maintain Your New Westlake - Saxony Country Split Shake Tile Roof

While your new roof is built to last, regular maintenance ensures it remains eligible for warranty claims and performs optimally.

Step 1
Visual Inspection After Storms

After any severe weather event, do a ground-level inspection. Look for dings in your gutters, tears in window screens, or broken, cracked, or displaced tiles. Don’t climb the roof yourself – call a professional if you suspect damage.

Step 2
Clean the Gutters and Downspouts

Keep gutters and downspouts clear at least twice a year and after major storms. Backups trap moisture and can damage your fascia, roof decking, and the tile system underneath.

Step 3
Trim Trees and Remove Debris

Keep trees trimmed back at least 6-10 feet from your roof edges to cut down on debris and protect tiles from impact damage.

Frequently Asked Questions

What safety measures should homeowners expect when a roofing contractor replaces a tile roof on a steep or multi-story home?
Steep-pitch tile work multiplies the standard risks in several directions - tile weighs far more than shingles, footing is harder to maintain, and fall distances grow with building height. Contractors working these roofs need rope-and-harness systems, reinforced ground protection for displaced tiles, and lift equipment sized to the job. The pace of work has to slow down, which adds to the timeline. Before signing any contract, confirm the contractor has hands-on, documented experience on high-pitch tile roofs specifically.
What heavy equipment is typically required for a large-scale concrete tile roof replacement?
Concrete tile is far heavier than asphalt shingles, and standard material handling doesn't hold up on large tile jobs. You need dumpsters sized for the demolished tile volume, forklifts for ground-level staging, and long-arm telehandlers that can lift pallets directly onto the roof. Without the right equipment, crews carry tile by hand - slowing the job and raising injury risk. Whether a contractor has access to proper lift equipment tells you a lot about how prepared they actually are for tile work at scale.
What unexpected conditions can be discovered beneath an old tile roof during tear-off, and how should contractors handle them?
Older tile roofs with organic underlayment can hide a lot - vegetation growth, animal activity, moisture damage to structural components. Not everything turns up in a pre-construction inspection. Some conditions only show up after tear-off begins. When that happens, contractors need to stop, document what they found, and talk to the property owner before going further, because some discoveries change the scope and cost. Clear change-order terms agreed to upfront protect everyone involved.
How do contractors protect an exposed roof deck from rain during a multi-week tile replacement project?
On a multi-week tile job, tearing off the full deck at once isn't a serious option. Experienced contractors work in sections - completing tear-off and underlayment installation in one zone before moving to the next, so no part of the deck sits open longer than it has to. One rain event on bare decking can run up costs that far exceed the price of the precaution. Any project spanning multiple weeks should include a written sequencing plan as part of the pre-construction agreement.
What is the difference between self-adhering leak barrier underlayment and standard roofing felt on a tile roof?
Standard felt gives you a basic moisture barrier, but it doesn't hold up well when tiles above it take hail or wind damage. Self-adhering leak barrier underlayment bonds directly to the deck, creating a sealed, watertight surface that keeps water out even when the tile layer is compromised. On a tile roof, the underlayment is the first real line of defense against leaks - the tile protects the underlayment, not the reverse. Getting that product selection right is one of the most important calls in any tile roof system.
Why is a detailed initial inspection especially important before a concrete tile roof replacement?
Tile roof replacements cost more, take longer, and involve more complex installation than standard shingle work. An incomplete inspection increases the odds of mid-project discoveries - structural damage, vegetation intrusion, animal activity - that force scope changes once work is already underway. A contractor who knows tile should be able to spot most of these conditions before the first tile comes off. How thorough that initial walkthrough is tells you a lot about how the rest of the job will go.
How should homeowners maintain a concrete tile roof to protect their investment long term?
Concrete tile needs less maintenance than asphalt shingles, but it still needs attention. After any major storm, do a ground-level check for cracked, displaced, or missing tiles, and look at your gutters for impact marks. Clear gutters and downspouts at least twice a year to prevent water backup and fascia damage. Keep trees trimmed back from the roof edge. Staying on top of these basics will add years to the life of the system.
